• Home
  • About Us
  • Services
  • GET FREE ESTIMATE
  • Portfolio
  • Service Area
  • Blog
Kitchen,Bath,Condo Remodeling In Chicago| Assembly Squad
  • Home
  • About Us
  • Services
  • GET FREE ESTIMATE
  • Portfolio
  • Service Area
  • Blog
Basement finishing cost Chicago 2026 -- Assembly Squad completed project

Basement Finishing Cost in Chicago: 2026 Per Sq Ft Guide

Updated April 12, 2026
Real per sq ft costs by room type, Chicago bungalow ceiling reality, waterproofing costs, permit timeline, and Viktor Aharon's Spring 2026 field report from active Assembly Squad basement projects
Viktor Aharon
Viktor Aharon, Assembly Squad Remodeling
April 12, 2026
↻ Updated April 12, 2026
18 min read

□ Chicago Basement Finishing — Field Report April 2026

  • Basement finishing demand is at a multi-year high at Assembly Squad: Remote work made the home office permanent. High mortgage rates killed the move-up market. Chicago homeowners are finishing their basements instead of moving — and we have more basement projects booked in Spring 2026 than any prior year since 2013.
  • The ceiling height problem is the #1 discovery that changes budgets: Chicago bungalows — our most common basement project type — typically have 6'6"–7'0" basement ceilings. After finishing (1" subfloor + ½" LVP + drywall ceiling), you're often at 6'4"–6'8". Chicago code requires 7'0" minimum for habitable rooms. This triggers either underpinning ($15,000–$35,000) or a careful design-around. We assess this on every free consultation — don't skip this step.
  • Waterproofing first is non-negotiable in 2026: Chicago's clay soil creates hydrostatic pressure no other major city deals with at our scale. Skipping waterproofing to save $6,000–$10,000 and then having $55,000 in finished walls destroyed by water is the most expensive mistake we see. Assembly Squad installs interior drain tile, sump pump with battery backup, and vapor barrier on every basement project before a single stud goes up.
  • Illinois-made cabinetry is the smart 2026 choice for wet bars and built-ins: Import tariffs at 25%+ on European cabinet brands add $2,000–$6,000 to a basement wet bar or built-in project. Illinois-made custom cabinetry — zero tariff, 4–6 week lead, custom sizing — is our standard specification and the smart financial choice in 2026's tariff environment.
  • Chicago ADU ordinance expanded April 1, 2026: The City Council voted 46-0 to expand basement ADU eligibility citywide. If your property is RT or RM zoned, 1–4 units, and built before 2006 — you can now convert your basement to a legal rental unit as-of-right. This has added a fourth tier to our basement finishing scope with rent potential of $1,200–$2,200/month.

Basement Finishing Cost Chicago 2026 — Quick Answer

Basement finishing in Chicago costs $55–$145 per square foot in 2026, or $35,000–$110,000+ for a typical 600–800 sq ft Chicago basement. Here's what each tier delivers:

  • Basic finish — $55–$75/sqft ($33K–$60K): Framing, drywall, LVP flooring, recessed lighting, paint, one egress window. No bathroom, no wet bar. Family room or home office use.
  • Mid-range — $75–$105/sqft ($45K–$84K): Everything above plus a full bathroom, waterproofing, HVAC extension, and finished laundry area. The most popular Assembly Squad basement package.
  • Premium — $105–$145/sqft ($63K–$116K): Wet bar with Illinois-made cabinetry, home theater, custom gym, premium tile, radiant heat floor, full bathroom, egress windows throughout.
  • ADU conversion — $130–$200+/sqft ($85K–$130K+): Full legal dwelling unit — separate entrance, kitchen, bathroom, egress, waterproofing, HVAC, electrical panel upgrade, all Chicago permits.

Chicago-specific note: Always add $6,000–$12,000 for waterproofing (non-negotiable), $1,000–$2,500 for permits, and 15% contingency for ceiling height or structural discoveries. Our median basement finishing project in Spring 2026 is $65,000 all-in.

— Viktor Aharon, Founder & CEO, Assembly Squad Remodeling LLC. 500+ Chicago projects since 2013. IL License #TGC098779. EPA Lead-Safe #NAT-F285417-1. Lincoln Park Design Studio: 2315 N Southport Ave. (312) 544-9150.

Basement finishing and basement remodeling are not the same thing — and confusing the two is the fastest way to get an estimate that doesn't match your actual project. Finishing means taking an unfinished, raw concrete basement and converting it into livable, code-compliant space. Remodeling means updating a basement that's already been finished. The costs are different. The permit requirements are slightly different. And the hidden-cost profile is completely different.

This guide is specifically about finishing an unfinished Chicago basement — the raw-concrete-to-finished-room journey — with real costs from our Spring 2026 project pipeline. If you have a finished basement that needs updating, see our Chicago basement remodel cost guide.

500+ Chicago basement projects completed by Assembly Squad since 2013
$65K Median Assembly Squad basement finishing project — Spring 2026 all-in
65–70% ROI on a properly waterproofed and finished Chicago basement at resale

Finishing vs. Remodeling — Why It Matters for Your Budget

FactorFinishing (Unfinished → Livable)Remodeling (Finished → Updated)
Starting conditionRaw concrete, exposed joists, no drywallExisting drywall, flooring, fixtures
WaterproofingAlways required — $6K–$12KMay not be needed
FramingFull stud wall framing requiredExisting framing reused or patched
ElectricalFull rough-in from panelExisting circuits often reused
Ceiling height riskHigh — often triggers underpinningAlready resolved in original build
Asbestos/radon riskHigher — materials more exposedUsually already remediated
Typical cost range$55–$145/sqft$35–$100/sqft
Permit requiredYes — alwaysDepends on scope
Timeline8–16 weeks4–10 weeks

Chicago Basement Finishing Cost Per Square Foot — 2026

Finish LevelCost/Sqft600 Sqft800 SqftWhat's Included
Basic$55–$75$33K–$45K$44K–$60KFraming, drywall, LVP, recessed lighting, paint, egress window
Mid-Range$75–$105$45K–$63K$60K–$84KAbove + full bathroom, waterproofing, HVAC extension, laundry area
Premium$105–$145$63K–$87K$84K–$116KWet bar, home theater, custom gym, premium tile, radiant heat
ADU Conversion$130–$200+$78K–$120K$104K–$160K+Full legal unit — kitchen, bath, entrance, all permits, panel upgrade

□ What's NOT in these numbers — always add:

  • Waterproofing: $6,000–$12,000 — interior drain tile + sump + battery backup. Non-negotiable in Chicago.
  • Permits: $1,000–$2,500 for the building permit. Assembly Squad files all permits included in project cost.
  • Radon mitigation: $800–$1,800 if elevated levels are found — test before finishing begins.
  • 15% contingency: For Chicago basements built before 1970 — ceiling height discoveries, asbestos floor tile, or structural issues are common.

Room-by-Room Basement Finishing Costs — Chicago 2026

□️ Family Room / Living Area

$18,000–$32,000
  • Framing and drywall
  • LVP or carpet flooring
  • Recessed LED lighting (8–12 cans)
  • Paint throughout
  • Electrical outlets to code
  • Egress window if needed ($3,500–$5,500)
  • No permit for non-bedroom use if no bathroom added

□ Full Bathroom

$18,000–$35,000
  • Sewage ejector pump if below grade drain ($2,500–$4,500)
  • Tile shower or tub/shower combo
  • Vanity, toilet, exhaust fan
  • Heated floor option ($1,200–$2,500)
  • Schluter waterproofing system
  • Express Permit — 3–5 business days
  • Most expensive per-sqft room in any basement

□ Wet Bar

$12,000–$28,000
  • Illinois-made custom cabinetry (zero tariff, 4–6 weeks)
  • Countertop — quartz or butcher block
  • Bar sink + plumbing rough-in
  • Under-counter refrigerator or beverage center
  • Backsplash tile
  • Pendant lighting over bar
  • Import tariff avoided: saves $2,000–$5,000 vs European brands

□ Home Office

$14,000–$24,000
  • Framing, drywall, egress window (required for legal bedroom/office)
  • Dedicated electrical circuits (20A for equipment)
  • Cat6 ethernet rough-in
  • LVP flooring, recessed lighting
  • Built-in desk or bookcase — Illinois-made option
  • Sound dampening between joists ($1,500–$3,000)
  • Separate HVAC zone or mini-split ($3,500–$5,500)

□ Home Theater

$20,000–$45,000
  • Acoustic wall treatment and insulation
  • Tiered seating platform framing
  • 4K projector or large-format TV rough-in
  • Surround sound wire rough-in (6–12 speaker locations)
  • Blackout lighting and dimmer controls
  • Premium carpet (theater standard)
  • Wet bar adjacent add: $12,000–$18,000

□️ Home Gym

$10,000–$22,000
  • Rubber flooring over subfloor (8–12mm, $4–$8/sqft installed)
  • Mirror wall (full-width, $1,500–$3,500)
  • Reinforced ceiling for TRX/pull-up bar ($800–$1,500)
  • 20A dedicated circuits for equipment
  • Exhaust fan — humidity control essential
  • Epoxy floor alternative ($3–$6/sqft) for heavier equipment
  • Mini-split for independent temp control ($3,500–$5,500)

What Will Your Chicago Basement Finishing Cost?

Free in-home assessment — we measure your space, check ceiling height, assess waterproofing needs, and deliver a fixed-price proposal within 48 hours. No surprises.

(312) 544-9150 Schedule at assemblyserviceil.com →

Basement Finishing Cost by Chicago Building Type

Chicago's building stock creates wildly different basement finishing conditions. The same $65,000 budget delivers a completely different result in a 1920s bungalow vs. a 1990s Lincoln Park townhome. Here's what to expect in each:

□ Chicago Bungalow (1910–1940)

  • Ceiling height: 6'6"–7'0" — the #1 issue. Code requires 7'0" minimum for habitable rooms. Often triggers underpinning ($15,000–$35,000) or careful design workarounds.
  • Foundation: Limestone rubble or early concrete — requires different waterproofing than poured concrete.
  • Floor: Original concrete often contains asbestos floor tile — test before grinding or demolition. Abatement: $2,000–$6,000.
  • Electrical: Often no basement circuits at all — full rough-in from panel required.
  • Typical finishing budget: $65,000–$110,000 including waterproofing and ceiling resolution.
  • Best use: Family room + bathroom + home office. Ceiling constraint limits theater and gym viability without underpinning.

□ Two-Flat / Three-Flat (1900–1940)

  • Ceiling height: Same as bungalow — 6'6"–7'0". Same code challenge.
  • ADU potential: With expanded April 2026 ordinance, two-flat and three-flat basements are now the #1 ADU conversion target in Chicago. Rent potential: $1,200–$2,000/month.
  • Shared systems: Plumbing stacks and electrical panels shared across units — coordinate work carefully.
  • Separate entrance: Many two-flats already have a basement entrance — this is what enables the ADU conversion.
  • Typical finishing budget: $75,000–$130,000 for ADU conversion. $55,000–$85,000 for personal-use finish.
  • Best use: ADU rental unit — fastest-growing basement project type at Assembly Squad in 2026.

□️ Greystone / Brownstone (1890–1930)

  • Ceiling height: Often 7'0"–8'0" — better than bungalows due to building scale.
  • Foundation: Limestone or brick — masonry waterproofing system required, not standard drain tile.
  • Access: Often narrow stair access, which complicates material delivery and egress window installation.
  • Potential: High ceilings and larger footprint (often 1,200–1,600 sq ft) make greystones excellent theater, gym, and entertainment basement candidates.
  • Typical finishing budget: $85,000–$150,000 for premium finish.
  • Best use: Entertainment suite — wet bar, theater, gym. High ceiling enables full-build-out.

□️ Post-War Single Family (1950–1980)

  • Ceiling height: 7'6"–8'6" — best of any Chicago building type. No underpinning needed in most cases.
  • Foundation: Poured concrete — easiest waterproofing, most reliable.
  • Electrical: Usually 100-amp panels — may need upgrade to 200-amp for full basement build-out ($3,500–$6,000).
  • Asbestos: 1950s–1970s homes commonly have asbestos floor tile and pipe wrap — test before any demo.
  • Typical finishing budget: $55,000–$95,000 for mid-range to premium finish.
  • Best use: Any use — best ceiling height and easiest construction conditions of any Chicago building type.

The Chicago Bungalow Ceiling Problem — Your Options

This is the conversation that surprises more Chicago homeowners than any other. You have a 1924 bungalow. You want to finish the basement. We come out and measure: 6'9" raw ceiling height. After a 1" subfloor, ½" LVP, ½" drywall ceiling — you're at 6'8". Chicago code minimum for habitable space is 7'0". You're 4 inches short. Now what?

SolutionCostResultBest For
Underpinning (lowering the floor)$15,000–$35,000Gains 12–24 inches, full 7'+ ceiling everywhereFull livable space, ADU, theater, gym
Bench footing$8,000–$18,000Gains 6–12 inches, creates perimeter ledgeGood compromise — partial height gain
Design-around$0–$2,000No height gained — use existing height creativelyStorage, utility, partial use
Exposed joist ceiling$1,500–$3,500Gains 6–10" by eliminating drywall ceilingIndustrial/modern aesthetic — loses insulation value
Do not finish$0No habitable space addedWhen numbers don't pencil out

Viktor Aharon's honest assessment: if your ceiling is below 6'10" raw, underpinning is almost always the right call for anyone wanting true livable space. The $15,000–$35,000 cost adds significantly more than that in finished basement value. If your ceiling is 6'10"–7'2", we can usually engineer around it with careful planning — exposed joist ceiling, thinner subfloor system, and strategic room layout.

Waterproofing — The Chicago Cost You Cannot Skip

Chicago sits on dense clay soil that holds water, expands during freeze-thaw cycles, and creates hydrostatic pressure against your foundation walls that most other American cities simply don't experience at our scale. This is not a theoretical problem — it's physics, and it's why every Assembly Squad basement project begins with waterproofing before a single stud goes up.

⚡ The Real Cost of Skipping Waterproofing

We see it every year. A homeowner finishes their Chicago basement without proper waterproofing to save $8,000. Two winters later, hydrostatic pressure cracks the foundation, water infiltrates, and $60,000 in finished walls, flooring, and cabinetry is destroyed. The remediation — tear everything out, waterproof properly, rebuild — costs $85,000. Assembly Squad will never start framing until waterproofing is complete. It's not optional, and any contractor who tells you otherwise is not protecting your investment.

Waterproofing ComponentCostWhy It's Needed
Interior drain tile system$4,000–$8,000Channels water away from foundation before it enters walls
Sump pump (primary)$800–$1,500 installedRemoves collected water from drain tile system
Battery backup sump pump$400–$800 installedOperates during power outages — Chicago storms knock out power
Vapor barrier (walls)$500–$1,200Prevents moisture migration through block/concrete walls
Radon mitigation system$800–$1,800Required if elevated levels found — test before finishing
Total waterproofing package$6,000–$12,000Non-negotiable in Chicago clay soil conditions

Illinois-Made Cabinetry for Basement Wet Bars and Built-Ins

The 2026 import tariff environment has made the cabinet choice for basement wet bars and built-ins a significant financial decision. Popular European wet bar cabinetry brands carry 25%+ import tariffs — adding $2,000–$6,000 to a typical basement wet bar project. Illinois-made custom cabinetry eliminates this entirely.

□□ Illinois-Made (Assembly Squad Standard)

  • Zero import tariff — made in Illinois
  • 4–6 week lead time — ordered at contract signing
  • Custom sizing for non-standard basement dimensions
  • Plywood box construction, soft-close hardware standard
  • Any style: Shaker, flat-front, inset
  • 50+ paint colors or real wood species
  • Locked-in pricing at contract signing

□ European / Asian Import

  • 25%+ import tariff applied at customs
  • 10–16 week lead time after customs clearance
  • Stock sizes — often require fillers in non-standard spaces
  • Construction quality varies widely by brand
  • Limited custom options at mid-range price points
  • Tariff can increase between order and delivery
  • Price not locked — exposed to tariff changes

Chicago Basement Finishing Permits — What You Actually Need

Work TypePermit Required?PathTimeline
Framing, drywall, flooring, paintYes — building permitStandard2–5 weeks
Electrical rough-in (new circuits)Yes — electrical sub-permitExpress Permit3–5 business days
Plumbing (bathroom, wet bar sink)Yes — plumbing sub-permitExpress Permit3–5 business days
HVAC extension / mini-splitYes — mechanical sub-permitExpress Permit3–5 business days
Egress window installationYes — included in building permitStandardWith main permit
Underpinning (floor lowering)Yes — structural engineering requiredStandard Plan Review4–8 weeks
ADU conversionYes — zoning + building + all subsStandard + Zoning Review6–12 weeks
Total permit fees (typical finish)$1,000–$2,500Assembly Squad files all — included in project cost

The Hidden Costs — What Chicago Basements Reveal During Demo

⚠️ Budget 15% Contingency — These Are Near-Certain in Pre-1970 Chicago Basements

  • Asbestos floor tile: Present in virtually every Chicago basement built between 1940–1980. Black 9"×9" tiles are almost always asbestos. Abatement before any grinding or demolition: $2,000–$6,000
  • Radon: Chicago is EPA Radon Zone 2 — moderate to high risk. Test before finishing. Mitigation system: $800–$1,800. Don't seal a basement with elevated radon without a mitigation system.
  • Old clay sewer lines: Pre-1950 basements often have deteriorating clay sewer lateral under the floor. Replacement during finishing (when floor is open) is far cheaper than after: $4,000–$10,000
  • Inadequate electrical panel: 60-amp or 100-amp panels common in older Chicago homes — cannot support basement finish without upgrade. Panel upgrade: $3,500–$6,000
  • Low ceiling discovery: The most common budget-changer. Measured at 6'8" raw — after finish materials, only 6'4". Underpinning: $15,000–$35,000
  • Foundation cracks: Common in Chicago clay soil. Active cracks require remediation before finishing. Cost: $2,000–$8,000 depending on severity

Before & After — Assembly Squad Chicago Basement Finishing

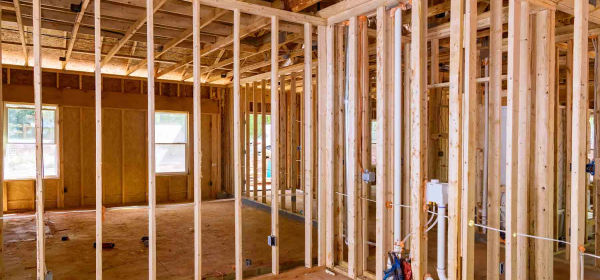

Before: Unfinished Chicago basement -- raw concrete and exposed joists

BEFORE

Raw concrete, exposed joists — typical Chicago unfinished basement

After: Finished Chicago basement -- Assembly Squad complete build

AFTER

Complete finish — family room, bathroom, wet bar, LVP flooring throughout

Project Snapshot — Chicago Bungalow Basement Finish, Logan Square

  • Home: 1928 Chicago bungalow, 650 sq ft raw basement
  • Ceiling challenge: 6'10" raw — bench footing added 8 inches, final finished ceiling 7'2"
  • Scope: Interior drain tile + sump + battery backup, bench footing, full framing and drywall, LVP throughout, recessed LED lighting, full bathroom, wet bar with Illinois-made cabinetry and quartz countertop, egress window, dedicated electrical circuits
  • Hidden cost encountered: Asbestos floor tile — abatement $3,800 (within contingency budget)
  • Total investment: $82,000 all-in including permits and waterproofing
  • Timeline: 14 weeks from permit filing to completion
  • Value added: Appraiser confirmed $58,000 increase in property value

Viktor Aharon's 3 Rules for Chicago Basement Finishing

From 500+ basement projects — the 3 things that consistently separate a successful finish from a costly mistake:

  • Rule 1: Measure the ceiling before you plan anything else. In Chicago, the ceiling height determines what your basement can become. Everything — the permit path, the scope, the budget, the use — flows from that number. If a contractor gives you a quote without measuring your ceiling height and assessing for code compliance, get a second opinion. Assembly Squad measures and assesses for free on every consultation.
  • Rule 2: Waterproof first, frame second. Always. This is not negotiable in Chicago's clay soil. The sequence of finishing before waterproofing is the single most common cause of total-loss basement renovations we see. We have walked away from projects where homeowners insisted on skipping waterproofing. We'd rather lose the project than watch someone lose their investment.
  • Rule 3: Test for asbestos and radon before breaking ground. Chicago pre-1980 basements almost always have asbestos floor tile. You cannot grind, cut, or demo that floor without abatement. And radon testing takes 48 hours — it costs $15 and protects your family. Both of these tests need to happen before you sign a contract with any contractor.

Related Chicago Basement Guides

Cost Guides

  • Basement Remodel Cost Chicago 2026
  • Basement ADU Cost Chicago 2026
  • Whole House Remodel Cost Chicago

Services & Areas

  • Basement Remodeling Chicago
  • Lincoln Park Basement Remodeling
  • Kitchen Remodeling Chicago

Frequently Asked Questions

How much does it cost to finish a basement in Chicago in 2026?

+

Basement finishing in Chicago costs $55–$145 per square foot in 2026. For a typical 600–800 sq ft Chicago basement: basic finish (family room, no bathroom) runs $33,000–$60,000; mid-range with bathroom and waterproofing runs $45,000–$84,000; premium with wet bar, theater, or gym runs $63,000–$116,000; ADU conversion runs $78,000–$160,000+. Always add $6,000–$12,000 for waterproofing, $1,000–$2,500 for permits, and 15% contingency. Assembly Squad's median basement finishing project in Spring 2026 is $65,000 all-in.

What is the minimum ceiling height to finish a Chicago basement?

+

Chicago building code requires 7'0" minimum ceiling height for habitable rooms (family rooms, bedrooms, home offices). After finishing materials — 1" subfloor, ½" LVP flooring, ½" drywall ceiling — you lose approximately 2" of raw ceiling height. So you need at least 7'2" raw to achieve 7'0" finished. Chicago bungalows typically have 6'6"–7'0" raw ceilings, which often triggers either underpinning ($15,000–$35,000 to lower the floor), bench footing ($8,000–$18,000 for a partial solution), or an exposed-joist ceiling design that eliminates the drywall ceiling to gain back 6–8 inches. Assembly Squad measures and evaluates ceiling height on every free consultation before any scope or pricing is discussed.

Is waterproofing required for a Chicago basement finish?

+

Chicago building code does not mandate a specific waterproofing method — but physics does. Chicago's clay-heavy soil creates hydrostatic pressure against foundation walls that most American cities don't experience. Finishing a basement without proper waterproofing in Chicago is the single most common cause of catastrophic, total-loss basement renovations we see — typically when water infiltration destroys $50,000–$80,000 in finished walls, flooring, and cabinetry. Assembly Squad installs interior drain tile, sump pump with battery backup, and vapor barrier on every basement project before framing begins. Cost: $6,000–$12,000. This is not optional on any project we accept.

Does finishing a basement in Chicago require a permit?

+

Yes — Chicago requires a building permit for all basement finishing work. This is not optional and cannot be legally skipped. The main building permit covers framing, drywall, and egress windows. Additional sub-permits are required for electrical work (Express Permit, 3–5 business days), plumbing for bathroom or wet bar (Express Permit, 3–5 business days), and HVAC work (Express Permit, 3–5 business days). Underpinning requires Standard Plan Review with structural engineering (4–8 weeks). ADU conversions require zoning review in addition to building permits (6–12 weeks). Total permit fees: $1,000–$2,500. Assembly Squad files all permits as part of every project — included in project management, no separate billing.

How long does basement finishing take in Chicago?

+

Timeline from permit approval to completion: basic finish (family room, no bathroom) 6–9 weeks; mid-range with bathroom 9–13 weeks; premium with wet bar and theater 12–16 weeks; ADU conversion 14–20 weeks. Add permit processing time before construction begins: main building permit 2–5 weeks, electrical/plumbing/HVAC Express Permits 3–5 business days each, underpinning Standard Plan Review 4–8 weeks. Assembly Squad files all permits the day after contract signing and orders cabinetry simultaneously so production runs parallel to permit approval. We provide detailed schedule at contract signing — no surprises.

What is the ROI on finishing a Chicago basement?

+

A properly waterproofed and finished Chicago basement returns 65–70% of cost at resale — meaning a $70,000 basement finish adds approximately $45,000–$50,000 in appraised home value. In neighborhoods where finished basement square footage is in high demand — Lincoln Park, Lakeview, Logan Square, Andersonville — the return is often higher. The key qualifier is "properly waterproofed" — a basement with water history or skipped waterproofing can actually reduce home value by raising inspection red flags. For homeowners planning to stay 5+ years, the lifestyle value (home office, entertainment space, ADU income) typically exceeds the financial return calculation. ADU conversions are the outlier — at $1,200–$2,200/month rental income, the investment often pays back in 4–7 years through rent alone.

How does the Chicago ADU ordinance affect basement finishing in 2026?

+

Chicago City Council voted 46-0 on September 25, 2025, to expand ADU eligibility citywide effective April 1, 2026. For basement finishing: if your property is RT or RM zoned, contains 1–4 units, and was built before 2006, you can now convert your basement to a legal rental unit as-of-right — no aldermanic approval required. Requirements for a legal basement ADU: minimum 7'0" ceiling height for habitable rooms, egress window in every bedroom (5.7 sq ft opening minimum), separate entrance (or shared with building entry), full kitchen with sink/cooking/refrigeration, full bathroom, mechanical ventilation, all Chicago permits including zoning review. Cost: $85,000–$130,000+. Typical rent: $1,200–$2,200/month depending on neighborhood. Most owners recoup their investment in 4–7 years through rental income alone. Assembly Squad has completed dozens of basement ADU conversions across Chicago's two-flats and three-flats.

Should I finish my Chicago basement myself or hire a contractor?

+

For cosmetic work like painting or installing floating floors over an already-finished basement, DIY is viable. For an unfinished basement in Chicago — particularly any pre-1980 home — we strongly recommend against DIY for three reasons: (1) Asbestos floor tile is present in most pre-1980 Chicago basements. Disturbing it without licensed abatement is illegal and dangerous. (2) Chicago building permits for basement finishing require licensed contractors for electrical, plumbing, and HVAC work — not optional. (3) Waterproofing must be done correctly on the first attempt — an improperly installed drain tile system can make water infiltration worse. The risk of a DIY basement in Chicago is not just getting it wrong — it's a failed home inspection, a rejected permit, and a destroyed investment when water gets in. Call us for a free assessment: (312) 544-9150.

Assembly Squad Chicago Basement Projects

See completed basement finishing projects from Assembly Squad across Chicago and the North Shore.

Assembly Squad Remodeling — Lincoln Park Design Studio: 2315 N Southport Ave, Chicago IL 60614

Viktor Aharon, Assembly Squad Remodeling

Viktor Aharon

Founder & CEO, Assembly Squad Remodeling LLC. Viktor has led 500+ kitchen, bathroom, and basement finishing projects across Chicago and the North Shore since 2013. Licensed Illinois General Contractor #TGC098779. EPA Lead-Safe Certified #NAT-F285417-1. NKBA Member. BBB A+ Rating. Lincoln Park Design-Build Studio: 2315 N Southport Ave. (312) 544-9150.

Ready to Finish Your Chicago Basement?

Free in-home assessment — we measure your ceiling height, assess waterproofing needs, check for asbestos and radon risk, and deliver a fixed-price all-in proposal within 48 hours. Illinois-made cabinetry, zero tariffs, locked-in pricing.

(312) 544-9150 Schedule at assemblyserviceil.com →

205 N Michigan Ave Suite 810 · 2315 N Southport Ave, Lincoln Park · IL License #TGC098779 · EPA #NAT-F285417-1

Assembly Squad
Remodeling

Chicago's boutique design-build remodeling company since 2013. Kitchen, bathroom, condo, basement, and whole-home renovations across Chicago and the North Shore.

IL #TGC098779
A+ BBB
NARI Chicago
NKBA Member
EPA Lead-Safe
$2M Insured
G H

Services

  • Kitchen Remodeling
  • Bathroom Renovation
  • Condo Remodeling
  • Basement Finishing
  • Whole Home Renovation
  • Attic Conversions
  • Custom Cabinets
  • Design-Build Studio

Explore

  • About Us
  • All Services
  • Project Portfolio
  • Service Areas
  • Lincoln Park Studio
  • North Shore
  • Blog
  • Contact Us

Contact

Phone(312) 544-9150
Headquarters205 N Michigan Ave, Suite 810
Chicago, IL 60601
Lincoln Park Studio2315 N Southport Ave
Chicago, IL 60614

Mon–Fri 9–6 · Sat 10–4

Chicago Neighborhoods

Lincoln Park · Gold Coast · River North · Lakeview · Wicker Park · West Loop · Bucktown · Logan Square · + more →

North Shore

Winnetka · Lake Forest · Highland Park · Evanston · Wilmette · Northbrook
Assembly Squad Remodeling LLC · All Rights Reserved ©2013–2026 · IL License #TGC098779 · A+ BBB · NARI Chicago
Privacy Policy Get a Free Estimate
  • Home
  • About Us
  • Services
  • GET FREE ESTIMATE
  • Portfolio
  • Service Area
  • Blog
